Why Are AI Data Centers Being Built? 5 Surprising Reasons

By

Robert Waithaka

·

·

7 min readReviewed
Why Are AI Data Centers Being Built? 5 Surprising Reasons

Why are AI data centers being built where they are? Walk into any town meeting where a campus is proposed and you will hear the same question — usually asked with suspicion. The answer is less mysterious than it seems. Data centers go where the five essential ingredients are cheapest and most available: power, water, fibre, land and tax treatment. This guide explains each one, why the locations are often surprising, and how to find out what is planned near you, with figures from the current reporting.

Why Are AI Data Centers Being Built? The Five Site Requirements#

RequirementWhy it mattersWhat the reporting says
PowerAI racks draw 50–150 kW each; campuses need gigawattsPower availability is now the primary constraint; interconnection waits exceed 5 years in Northern Virginia
WaterCooling towers evaporate 70–80% of withdrawn waterTwo-thirds of data centers built since 2022 are in water-stressed areas
FibreModels move huge datasets between buildingsUltra-low-latency fibre links and interconnection hubs are decisive for inference
LandCampuses can span hundreds or thousands of acresAverage site: ~224 acres (2024); largest exceed 1,000 acres
Tax treatmentIncentives decide where the economics work~35 US states offer data-center tax breaks

Table: the five things a data center site needs. Sources: Hanwha Data Centers; WRI; Guardian; Consumer Reports; Harvard Gazette; Lincoln Institute.

That list explains "why are they building data centers near me" better than any conspiracy theory. If your region has cheap power, available land, good fibre and an incentive package, developers will look at it — even if it seems remote.

Why Cheap Power Beats Cheap Land#

Land is a one-time cost; electricity is forever. A campus consuming gigawatts will spend more on power in its first year than on its entire site, which is why developers choose regions with cheap, abundant electricity over places where land is simply inexpensive. Texas, Ohio and the Midwest have become hotspots partly because of power prices and grid capacity, while Northern Virginia — despite land scarcity and long interconnection queues — remains the world's biggest AI hub because of its fibre density, utilities and tax incentives. Power, not dirt, is the real currency.

Latency: Some Workloads Must Sit Near Users#

Not all AI work can happen far away. Training a model is a batch job: it can run for weeks in a remote campus with cheap power. Inference — answering a user's prompt — needs to feel instant. If a chatbot, voice assistant or autonomous vehicle waits on a round trip to a distant server, the experience degrades, which is why inference workloads increasingly run closer to users, in regional and edge facilities. This split explains the shape of the map: giant training campuses in rural power hubs, smaller inference facilities near cities, and fibre-rich interconnection centres in between.

Climate as a Cooling Input#

Climate is a quieter factor. Cooler regions need less cooling energy, and arid climates are thought to reduce corrosion of equipment — which is one reason developers are drawn to dry, sparsely populated areas. But climate has a trap: the same dry places are often water-stressed, and evaporative cooling competes with farms and towns for scarce water. The Guardian's analysis found 517 of 809 planned US data centers are in areas that were in drought over the past year. Cool and wet beats hot and dry in the cooling math, but water availability is becoming the deciding vote.

Where the Big Builds Are Happening#

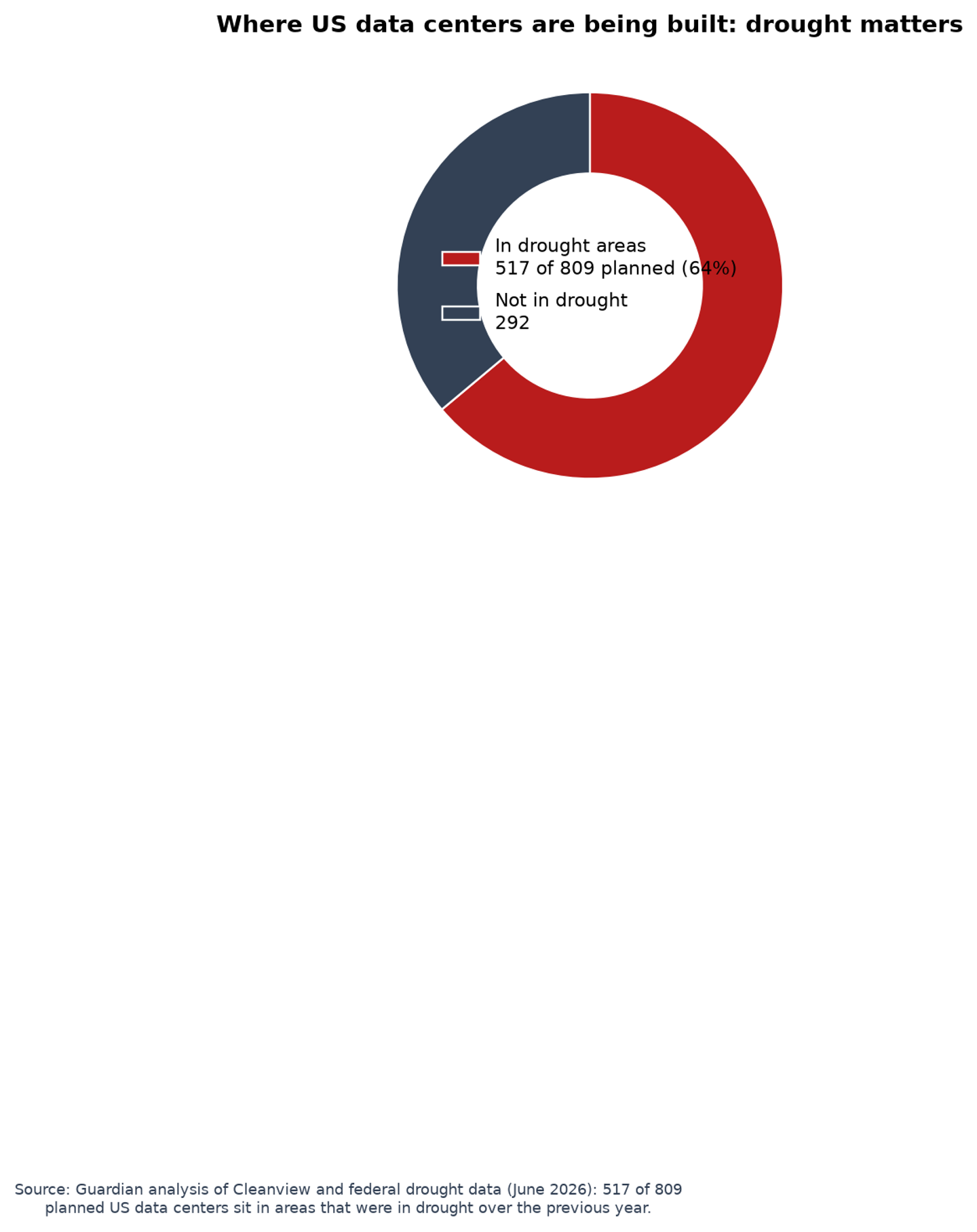

Figure: 517 of 809 planned US data centers sit in areas that were in drought over the previous year. Source: Guardian analysis of Cleanview and federal drought data (June 2026).
RegionWhat's happeningPressures
Northern Virginia~600 facilities; ~40% of state electricity (2024)Interconnection waits >5 years; water strain
Texas500+ facilities; new campuses in drought-hit countiesData centers could use 9% of state water by 2040
OhioPike County 10 GW proposal; state rate rulesGrid capacity; political fight
UtahStratos: ~40,000 acres, up to 9 GWGreat Salt Lake; referendum attempt
United Kingdom~100 new centers planned by early 2030s84% in areas projected water-stressed by 2040
Arizona26 data centers built or announced since 2022Colorado River drought; aquifer limits

Table: where data centers are being built now and the pressures each region faces. Sources: Consumer Reports; CNBC; Chatham House; Guardian.

This is also the answer to "data centers by country": the US hosts roughly 37% of the world's facilities, with the UK, Ireland and the Nordics carrying big shares in Europe — and China building its own enormous campuses, though with far less public reporting.

The Politics: Incentives, Moratoria and Referendums#

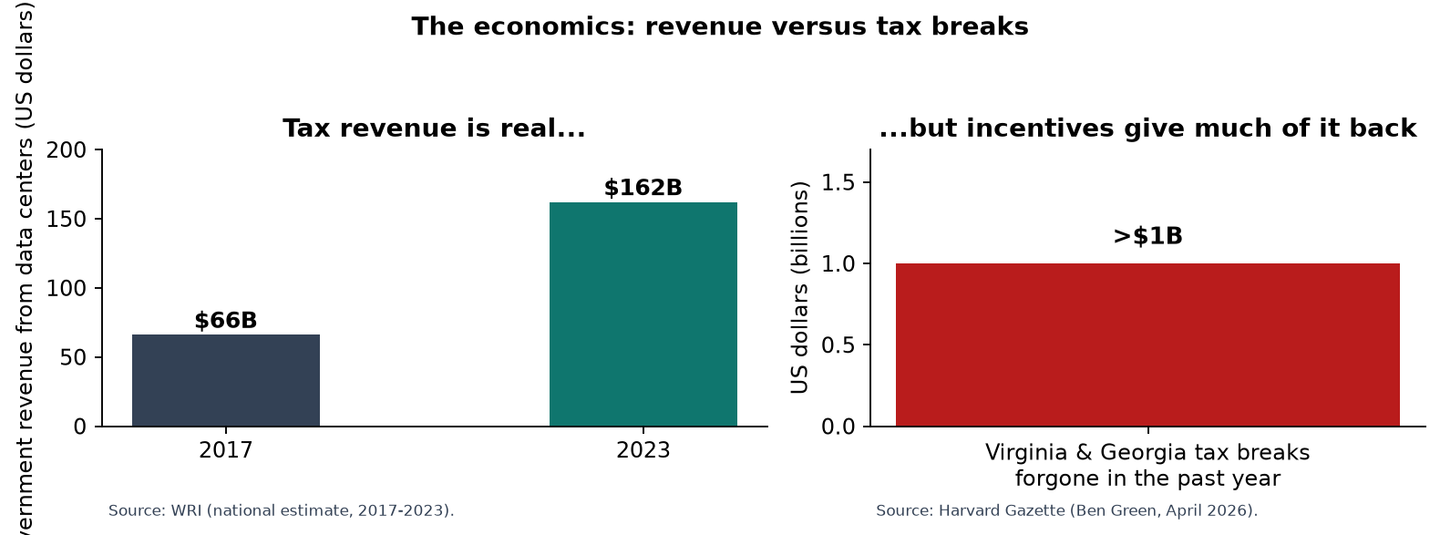

Figure: government revenue from the data-center sector grew from $66B (2017) to $162B (2023), while Virginia and Georgia gave up more than $1B in tax breaks last year alone. Sources: WRI; Harvard Gazette.

The politics of location are intense. Roughly 35 states court data centers with tax incentives, yet the same facilities face mounting opposition: a Gallup poll found 70% of Americans oppose building data centers in their communities. New York imposed the nation's first yearlong moratorium on large facilities; Pennsylvania now requires developers to pay for all new grid infrastructure; Ohio utilities make them pay for at least 85% of subscribed capacity; Texas is demanding companies fund electrical upgrades. The grid strain is measurable: data centers already consume roughly 40% of Virginia’s electricity, and 2025 saw more than $60 billion in US rate increases, with average prices up nearly 10%.

Figure: data centers use roughly 40% of Virginia’s electricity, and US rate increases approved in 2025 exceeded $60 billion. Sources: Bloomberg via Consumer Reports; WRI.

Local referendums, lawsuits and moratoria are becoming standard parts of the approval process.

Case Studies: Contested Builds#

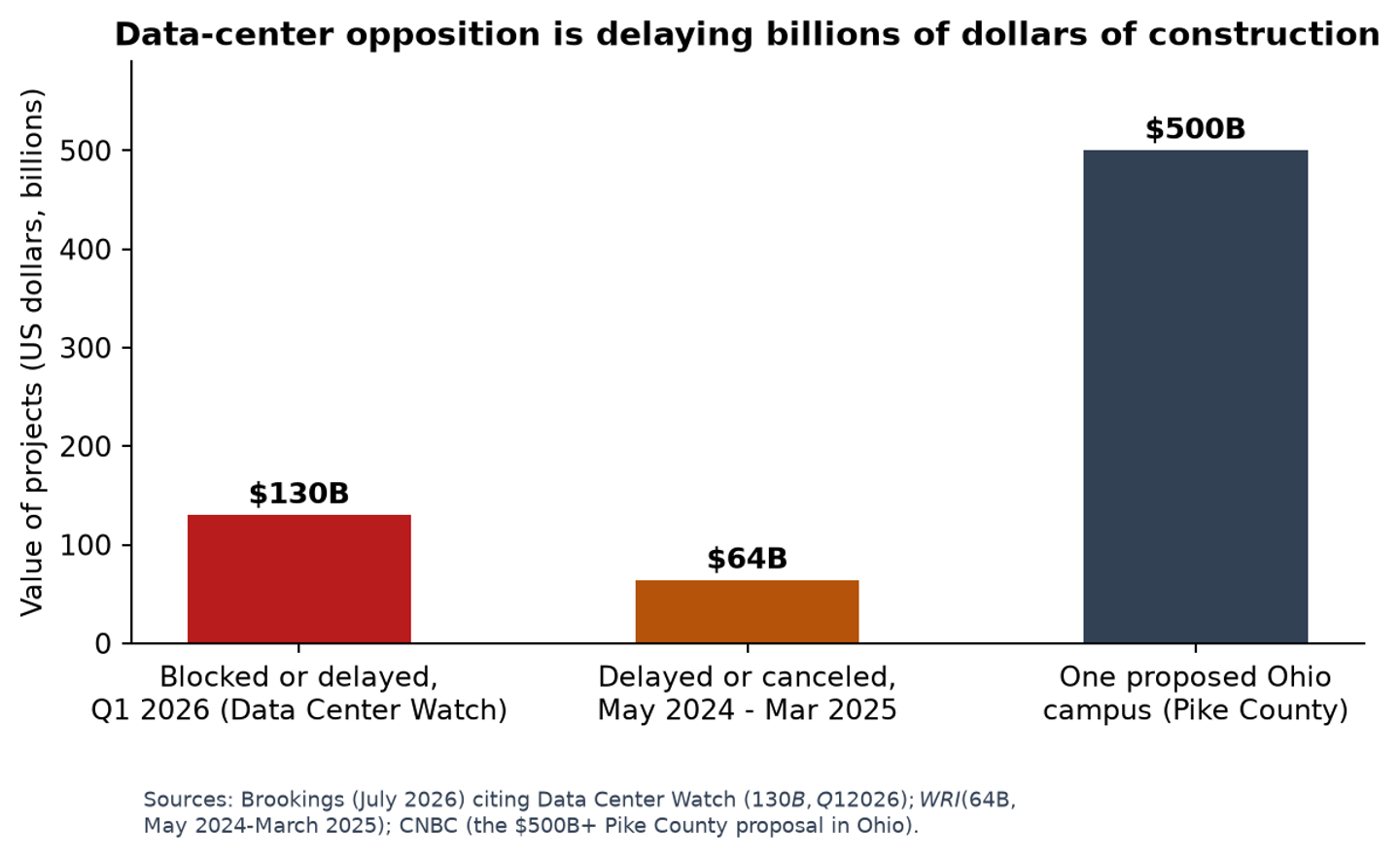

Figure: $130B of projects were blocked or delayed in Q1 2026 alone; $64B were delayed or canceled between May 2024 and March 2025; one Ohio proposal is worth $500B+. Sources: Brookings; WRI; CNBC.
ProjectWhereWhat happened
StratosUtahApproved despite drought; opposition group seeking a referendum; lawsuit filed
Saline Township (Stargate)MichiganLocal officials voted to reject; developers sued the town and construction began
Project Blue (AWS-linked)ArizonaCanceled after residents and leaders opposed projected water use
xAI ColossusMemphis30+ gas turbines; NAACP filed notice of intent to sue over air quality
HyperionLouisianaThree new gas plants approved to power it; farm-water concerns
Pike County campusOhio10 GW proposal became a state election issue

Table: contested AI data center builds and how each played out. Sources: Guardian; Schneier & Sanders via The Guardian; Aquatech; WRI; CNBC.

How to Find Out What's Planned Near You#

MethodWhat to look for
Local planning board / county agendaZoning changes, site-plan applications, public hearings
Utility interconnection queuePublic filings of large new grid-connection requests
Data center maps (e.g. Data Center Map, Cleanview)Operational, under-construction and proposed facilities
State energy docketsRate cases, transmission approvals, incentive awards
Municipal recordsPermits, non-disclosure agreements, community benefit agreements

Table: public ways to discover planned data centers in your area. Sources: Guardian; USA Today; WRI; Lincoln Institute.

One honest warning: developers and local officials frequently sign non-disclosure agreements — a WRI review found 80% of Virginia municipalities with data-center projects had NDAs in place — so some information will be hidden until it is too late to comment. Attend hearings early and ask for peak water and power figures, not annual averages.

The Bottom Line#

Where data centers get built is not random and not secretive in its logic: follow the power, water, fibre, land and tax breaks. The controversies are real — drought-stressed sites, ratepayer costs and few permanent jobs — but the decision framework is knowable. Our companion explainer on what an AI data center is covers the buildings themselves, and our AI water use and energy per prompt pieces explain the footprint once they are built. If the terms are new, the AI glossary is the place to start.
